Data Center Approvals in India: A Project Manager's Checklist for Land, Power, Fire, Building, Environment, and Telecom

By Aakash Ahuja··19 min read

Data center approvals in India should not be managed as paperwork after design is complete. Approvals are a critical-path workstream because land use, building plan approval, fire NOC, power connection, DG backup, fuel storage, water, environmental permissions, and telecom right-of-way can directly affect site selection, design freeze, procurement, commissioning, and go-live.

The practical mistake is to create an approval list without creating an approval dependency map. A project manager needs to know who owns each approval, which authority is involved, which documents are needed, what design decisions affect the approval, what the evidence will look like, and which milestone is blocked if approval slips.

This is the fifth article in AakashX's Data Center Project Management in India series, building on the site selection gate, the power planning workstream, and cooling and water planning from the pillar guide.

Table of Contents

  • What is the practical answer for data center approvals in India?
  • Why do approvals become a critical-path risk?
  • What makes data center approvals in India location-specific?
  • Which land, zoning, and building approvals should be mapped?
  • How should fire NOC and life-safety approvals be handled?
  • Which power, DG, fuel, and electrical approvals affect the project?
  • Which water, sewerage, groundwater, and environmental approvals may apply?
  • How should telecom and fiber right-of-way be planned?
  • How should state incentives and single-window systems be used?
  • What usually fails in data center approval management?
  • Data Center Approvals Tracker Template
  • FAQ
  • Key Takeaways

What is the practical answer for data center approvals in India?

Data center approvals in India should be managed as an integrated approval tracker covering land, zoning, building plan, fire NOC, power connection, electrical safety, DG backup, fuel storage, water, groundwater, sewerage, environmental and pollution permissions, telecom right-of-way, labour and safety registrations, local municipal permissions, and state incentive applications.

The exact approval list varies by state, city, land type, facility size, power architecture, water source, cooling design, DG capacity, fuel system, telecom layout, and operating model. Treat this article as a project-management framework, not legal advice.

Snippet-ready answer: Data center approvals in India are not a single permit. They are a set of land, building, fire, power, environmental, water, telecom, safety, and local-authority approvals that must be tracked as project dependencies from feasibility to handover.

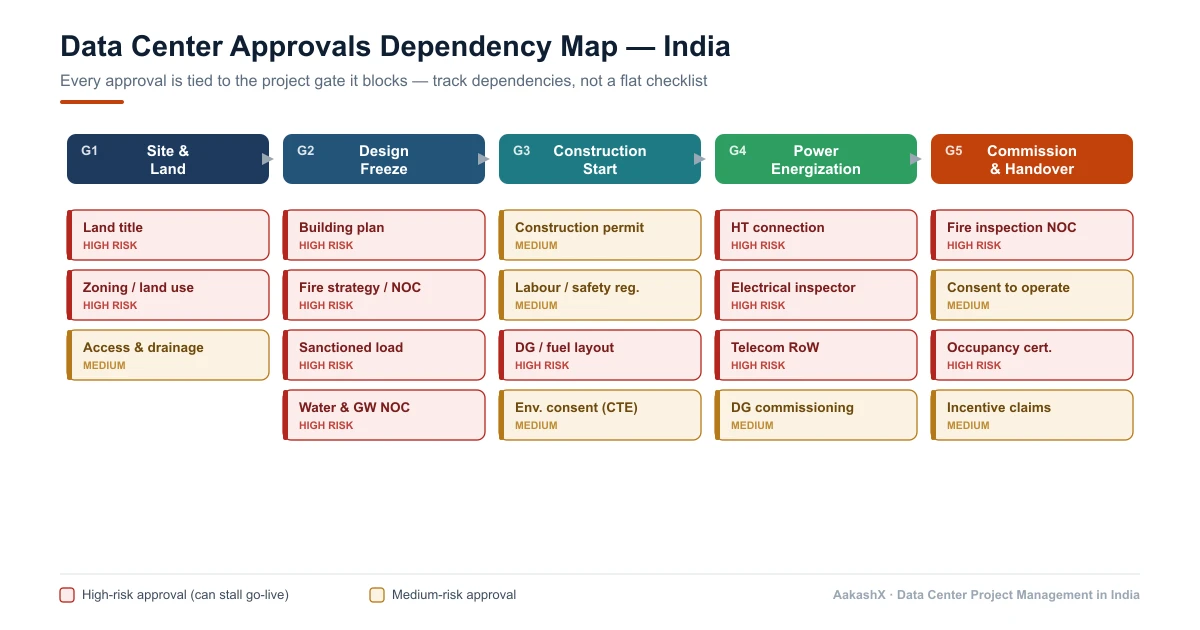

Data center approvals dependency map for India: land, building, fire, power, DG and fuel, water and environment, telecom, and incentive approvals mapped to the project gates they block, from site commitment through energization, commissioning, and handover.
Data center approvals dependency map for India: land, building, fire, power, DG and fuel, water and environment, telecom, and incentive approvals mapped to the project gates they block, from site commitment through energization, commissioning, and handover.

Why do approvals become a critical-path risk?

Approvals become a critical-path risk because they are tied to design, site, power, construction, commissioning, and operations.

Approval dependencyWhat it can block
Land use / zoningsite commitment, building plan, financing, construction start
Building plan approvalcivil construction start
Fire NOC / fire approvaloccupancy, commissioning, go-live, insurance confidence
Power connection / sanctioned loadenergization, testing, commissioning
DG / fuel permissionsbackup power readiness
Water / groundwater / seweragecooling design and operations
Pollution / environment approvalsconstruction, DG, wastewater, operation
Telecom right-of-wayfiber availability and network readiness
Labour / safety registrationsconstruction and operational compliance
State incentive approvalsbusiness case, financial assumptions, policy benefits
CEEW's 2026 India data center analysis notes that, despite single-window clearance provisions, stakeholders still report delays in land acquisition, building approvals, grid connectivity, and fire safety clearances. That is exactly why approvals should be managed as a PMO workstream, not as a closing checklist. (CEEW)

The project-management rule is simple:

If an approval can block construction, energization, commissioning, occupancy, or operations, it belongs on the critical path.

What makes data center approvals in India location-specific?

Data center approval requirements in India are location-specific because land, buildings, fire services, electricity distribution, water, local municipal matters, and industrial permissions are often handled through state, local, or utility-specific processes.

MeitY's Draft Data Centre Policy 2020 proposed several enabling ideas, including Data Centre Parks, single-window clearances, published approval lists, pre-provisioned clearances in data centre parks, quality power, renewable energy, and robust connectivity. (MeitY Draft Data Centre Policy 2020)

That policy direction matters. But project teams should not confuse policy intent with approval completion.

A data center PMO should distinguish four things:

ConceptMeaningProject risk
Policy incentiveA state or central benefit that may applyMay not remove local approvals
Single-window systemA portal or facilitation mechanismDoes not automatically eliminate authority-level review
Approval grantedFormal approval / NOC issuedMay still have conditions
Compliance maintainedOngoing adherence after approvalRequires operations discipline
The National Single Window System provides access to a large number of central and state approvals and helps investors identify and apply for regulatory approvals. For a data center project, this is useful as a discovery and filing layer, but the PMO still needs a project-specific tracker.

Which land, zoning, and building approvals should be mapped?

Land and building approvals should be mapped before the site is treated as final.

The project team should validate:

  • land title,
  • encumbrances,
  • permitted land use,
  • zoning classification,
  • land conversion requirement,
  • industrial or commercial use permission,
  • layout approval,
  • building plan approval,
  • height and setback conditions,
  • access road conditions,
  • stormwater and drainage requirements,
  • occupancy or completion certificate requirements.
A data center site can look strong technically and still be weak if land use, title, zoning, or building-plan approval is uncertain.

Land approval checklist

ItemWhy it matters
Title diligencePrevents ownership and litigation risk
Zoning / permitted useConfirms whether a data center use is allowed
Land conversionMay be needed if current land use does not fit
Building plan approvalControls construction start and compliance
Access road statusAffects heavy equipment, emergency access, and operations
Drainage and stormwaterAffects flood and civil design risk
Completion / occupancy conditionsAffects handover and go-live
This should be validated with local counsel, land consultants, architect, owner's engineer, state industrial authority, and local municipal authority.

How should fire NOC and life-safety approvals be handled?

Fire approval should start during concept design, not after construction.

Data centers have electrical rooms, UPS and battery systems, generators, fuel systems, cable trays, server halls, cooling equipment, security zones, and restricted access areas. Fire and life-safety planning therefore has to be integrated with architecture, MEP, power, security, and operations.

The National Building Code fire and life-safety material covers fire prevention, life safety, and fire protection requirements for buildings. (National Building Code of India — Part 4 Fire and Life Safety) Exact fire NOC process and enforcement vary by state and local fire authority, so the local fire consultant should be involved early.

Fire approval should review

  • occupancy classification,
  • fire access road,
  • fire tender movement,
  • fire water tanks,
  • hydrants,
  • sprinklers,
  • detection and alarm systems,
  • clean-agent or suitable suppression system where applicable,
  • battery room safety,
  • generator and fuel areas,
  • emergency exits,
  • compartmentation,
  • cable penetration sealing,
  • smoke management,
  • fire command center where applicable,
  • emergency lighting and signage,
  • evacuation procedures,
  • fire system testing and maintenance.

Fire NOC as a project gate

Do not treat fire NOC as a late-stage inspection item. Track it through:

  • concept fire strategy,
  • fire consultant appointment,
  • fire drawings,
  • authority consultation,
  • submission,
  • inspection,
  • observations,
  • closure,
  • NOC,
  • renewal or periodic compliance, where applicable.
Snippet-ready answer: Fire NOC for a data center should be planned from concept design because fire access, detection, suppression, electrical rooms, battery systems, DG areas, fuel storage, cable routing, compartmentation, and emergency procedures can all affect approval.

Which power, DG, fuel, and electrical approvals affect the project?

The power workstream can contain several approval dependencies.

Depending on state, utility, capacity, and design, the project may need to manage:

  • sanctioned load application,
  • HT connection approval,
  • substation or feeder work,
  • right-of-way for electrical line or cable,
  • transformer and switchgear approvals or inspections,
  • electrical inspector approval,
  • metering approval,
  • energization permission,
  • DG installation permissions,
  • fuel storage permissions,
  • fire approval for DG and fuel areas,
  • emissions and noise compliance,
  • open access approvals if applicable.
The Central Electricity Authority's 2023 safety and electric supply regulations are a relevant national electrical-safety reference point, but local electrical inspectorate and DISCOM requirements still need project-specific validation.

The Central Pollution Control Board maintains genset notification material covering generator-set emission and noise requirements and certified equipment references. DG backup should therefore be treated as both a power-readiness dependency and a compliance dependency.

Power approval tracker

DependencyOwnerEvidence
Sanctioned loadelectrical consultant / DISCOM liaisonapplication, correspondence, sanction letter
HT connectionelectrical consultanttechnical terms, approved drawings, connection process
Electrical inspectorlicensed contractor / consultantinspection records, approval
Substation / feederDISCOM / STU / ownerscope, timeline, right-of-way note
DG installationMEP / electrical vendorapproved specs, site layout, compliance records
Fuel storagesafety / fire consultantpermission, layout, safety compliance
Open accessenergy consultantapplication, approvals, agreements
Power approvals are tightly linked to the previous workstream: power planning for data centers in India.

Which water, sewerage, groundwater, and environmental approvals may apply?

Water and environmental approvals depend on the site, cooling method, water source, wastewater discharge, DG backup, fuel storage, and local regulatory classification.

The approval tracker may need to cover:

  • municipal water connection,
  • industrial water permission,
  • groundwater NOC,
  • treated wastewater supply arrangement,
  • water storage permission where applicable,
  • sewerage connection,
  • wastewater discharge permission,
  • consent to establish and consent to operate where applicable,
  • DG emissions and noise compliance,
  • hazardous waste or battery waste handling,
  • fuel storage and spill control,
  • stormwater drainage approval.
CGWA and NOCAP guidance is relevant where groundwater extraction may be involved, with the exact applicability depending on jurisdiction and state groundwater authority rules.

Cooling and water planning should therefore be linked to approvals from the start: cooling and water planning for Indian data centers.

Water and environment approval checklist

QuestionWhy it matters
What is the water source?Determines permission path
Is groundwater involved?May trigger NOC requirements
Is treated wastewater used?Requires supply and quality validation
Where does wastewater go?Determines discharge / sewerage approvals
Does DG backup trigger pollution or noise compliance?Affects equipment, layout, and approvals
Is fuel storage present?Affects fire, safety, spill control
Are batteries used?Affects disposal and safety requirements
Do not assume that a cooling strategy is approved just because the MEP design is ready. The water and environmental assumptions behind it must be approved or risk-accepted.

How should telecom and fiber right-of-way be planned?

Telecom approval risk is often underestimated because project teams assume fiber is commercially available.

For a data center, the PMO should distinguish:

  • carrier availability,
  • physical route diversity,
  • right-of-way permissions,
  • duct access,
  • road-cutting permissions,
  • building entry path,
  • meet-me-room readiness,
  • last-mile security,
  • restoration responsibility.
The Indian Telegraph Right of Way Rules, 2016, as amended, provide a framework for establishing, maintaining, working, repairing, transferring, or shifting underground telegraph infrastructure, with permissions handled through appropriate authorities.

For project management, the key issue is not only legal permission. It is physical readiness.

Telecom and fiber tracker

ItemEvidence required
Carrier shortlistcommercial proposals
Route mapphysical route drawings
Diversity validationconfirmation of separate paths
RoW requirementauthority and filing requirement
Road-cutting permissionslocal approval records
Building entryapproved entry plan
Meet-me-roomlayout and access control plan
TestingOTDR / test reports and handover records
Fiber should be tracked like power: commercial assurance is useful, but not enough. Physical route validation matters.

How should state incentives and single-window systems be used?

State incentives and single-window systems are useful, but they should not replace approval governance.

Use them for approval discovery, application filing, policy eligibility, incentive claims, escalation visibility, and document management.

Do not use them as a reason to weaken the PMO tracker.

CEEW notes that state policies are a major driver of data center investments and capacity build-out in India, but also reports implementation delays around practical approvals. (CEEW)

A project team should create a separate state incentive tracker covering:

  • eligibility criteria,
  • minimum investment condition,
  • employment condition, if any,
  • power tariff or duty benefit,
  • stamp duty or land benefit,
  • capital subsidy, if any,
  • renewable power benefit,
  • application timeline,
  • documents required,
  • approval conditions,
  • compliance obligations after approval.
Do not include financial benefits in the business case until eligibility and application assumptions have been reviewed by the appropriate advisors.

What usually fails in data center approval management?

1. The team creates an approval list but not a dependency map

An approval list says what is needed. A dependency map says what gets blocked if approval slips.

2. Fire review starts too late

Fire strategy affects layout, access roads, electrical rooms, battery areas, DG yards, fuel systems, suppression, exits, and commissioning. Late fire observations can force redesign.

3. Power approval is treated as a utility follow-up

Sanctioned load, HT connection, feeder path, substation readiness, inspection, and energization can become project blockers. These should be reviewed weekly.

4. Land-use assumptions are accepted too early

A site is not ready just because land is available. Permitted use, zoning, conversion, access, and building approval must be validated.

5. DG and fuel are treated as procurement items

DG backup creates compliance dependencies around emissions, noise, fuel storage, fire safety, acoustic treatment, exhaust, testing, and maintenance.

6. Telecom right-of-way is ignored until network buildout

If road-cutting, duct access, or right-of-way permissions are delayed, network readiness can slip even after the building is complete.

7. State incentives are assumed before eligibility is proven

An incentive is not real for the project until eligibility, application, approval conditions, and compliance obligations are clear.

8. Approval evidence is not stored centrally

Emails, meeting notes, consultant updates, portal screenshots, NOCs, drawing approvals, and inspection observations should be stored in a central approval evidence repository.

Data Center Approvals Tracker Template

Use this tracker from feasibility onward.

Approval areaPossible approval / NOCAuthority / stakeholderOwnerDependencyEvidenceStatusRisk
Landtitle diligencelocal counsel / land authoritylegalsite commitmenttitle memopendinghigh
Land usezoning / conversionlocal / state authoritylegal / real estatebuilding planapproval notependinghigh
Buildingbuilding plan approvalmunicipal / local authorityarchitectconstruction startapproved drawingspendinghigh
Firefire NOC / fire approvalfire authorityfire consultantconstruction / go-liveNOC, inspection reportpendinghigh
Powersanctioned loadDISCOMelectrical consultantdesign / procurementsanction letterpendinghigh
ElectricalHT connection / inspector approvalDISCOM / electrical inspectorelectrical consultantenergizationapproval / inspectionpendinghigh
DGgenerator complianceCPCB / state pollution / fire / safetyMEP / vendorbackup readinesscompliance documentspendingmedium-high
Fuelfuel storage permissionfire / safety / local authoritysafety consultantDG operationapproval / NOCpendinghigh
Watermunicipal / industrial waterlocal authorityutilities leadcooling operationconnection / permissionpendinghigh
Groundwatergroundwater NOCCGWA / state authority where applicablewater consultantcooling operationNOCpendinghigh
Seweragedischarge / seweragemunicipal / pollution authoritycivil / MEPoperationsapprovalpendingmedium
Environmentconsent / clearance where applicableSPCB / MoEFCC / local authorityenvironment consultantconstruction / operationCTO / CTE / approvalpendingmedium-high
Telecomfiber RoW / road cuttinglocal authority / carriertelecom leadnetwork readinesspermission, route mappendinghigh
Labour/safetyconstruction labour / safety registrationslabour / safety authorityEPC / adminconstructionregistrationpendingmedium
Incentivesstate data center incentive applicationstate nodal agencyfinance / legalbusiness caseapplication / approvalpendingmedium

Approval tracker operating rhythm

Review the tracker weekly during feasibility, site selection, design, and construction.

Each approval should have:

  • named owner,
  • authority,
  • document list,
  • submission date,
  • expected evidence,
  • dependency,
  • risk rating,
  • escalation path,
  • latest status,
  • next action.

Approval dependency sequence

Site Shortlist
  -> Land / Zoning / Access Validation
  -> Concept Design
  -> Building Plan + Fire Strategy + Power Application
  -> Detailed Design
  -> Construction Permissions + Utility Coordination
  -> Power Energization + Fire Inspection + Telecom RoW
  -> Testing and Commissioning
  -> Occupancy / Operations Readiness / Handover

Frequently Asked Questions About Data Center Approvals in India

What approvals are needed for a data center in India?

Data center approvals in India may include land-use approval, building plan approval, fire NOC, power connection, electrical inspector approval, DG and fuel permissions, water and sewerage permissions, groundwater NOC where applicable, pollution and environment approvals, telecom right-of-way, and state incentive applications. The exact list depends on state, city, land type, design, water source, power architecture, and operating model.

Is there a single approval for setting up a data center in India?

No. A data center usually requires multiple approvals from different authorities, utilities, and local bodies. A single-window system may help identify and apply for approvals, but it does not remove the need for project-level approval tracking.

When should fire NOC planning start?

Fire NOC planning should start during concept design. Fire access, electrical rooms, UPS and battery areas, DG yards, fuel storage, cable routes, suppression systems, exits, and emergency procedures can all affect design.

Who should own the data center approval tracker?

The PMO should own the tracker, but each approval should have a named functional owner. Legal, real estate, architect, MEP consultant, electrical consultant, fire consultant, environmental consultant, telecom lead, EPC contractor, and finance may each own different approval items.

Are state data center incentives automatic?

No. State incentives usually depend on eligibility conditions, application procedures, investment thresholds, compliance requirements, and approval by the relevant authority. They should be tracked separately and not assumed in the business case until validated.

Do data centers need environmental approvals?

They may, depending on site, size, DG backup, fuel storage, water use, wastewater discharge, construction activity, and state pollution-control requirements. Validate this with an environmental consultant and the relevant pollution-control authority.

Why are telecom right-of-way approvals important?

A data center needs reliable and diverse fiber connectivity. If right-of-way, road-cutting, duct access, or building-entry permissions are delayed, network readiness can slip even if the facility construction is complete.

What is the biggest approval-management mistake?

The biggest mistake is treating approvals as a checklist instead of a dependency system. Each approval should be tied to the milestone it can block, the owner responsible, the evidence required, and the escalation path.

Key Takeaways

  • Data center approvals in India must be managed as a critical-path PMO workstream, not as paperwork.
  • The approval list varies by state, city, land type, design, water source, power model, DG and fuel system, and telecom route.
  • Fire NOC, power approval, building approval, water permissions, and telecom right-of-way can directly affect go-live.
  • Single-window systems are useful, but they do not replace a project-specific approval tracker.
  • DG backup creates compliance dependencies around emissions, noise, fuel storage, fire safety, and maintenance.
  • State incentives should be tracked separately from statutory approvals.
  • Every approval should have an owner, authority, document list, dependency, evidence type, status, risk rating, and escalation path.
This article is part of AakashX's Data Center Project Management in India field manual. Start with the master guide, Project Managing a Data Center Setup in India, revisit Cooling and Water Planning for Indian Data Centers, continue with Data Center Project Governance, and work through the rest of the series. Before freezing site or design, build the approval tracker above and convert every "we will get it later" assumption into a named owner, evidence requirement, and milestone dependency.

References

Data CentersTechnologyStrategySeriesJune 13, 2026
Share
Aakash Ahuja

Aakash Ahuja

Enterprise AI, Cybersecurity & Platform Engineering

Aakash writes about secure AI agents, microservices architecture, enterprise platforms, and production engineering. He has 20+ years of experience building and operating software systems across banking, cloud, cybersecurity, AI, and enterprise workflow automation. He is the founder of ITMTB and teaches AI, Big Data, and Reinforcement Learning at top institutes in India.
