Data Center Certification Planning: Tier III, Tier IV, TIA-942, Design Reviews, and Commissioning Evidence

By Aakash Ahuja··16 min read

Data center certification planning should not start after construction is complete. By then, the project may have already locked design decisions, vendor packages, equipment substitutions, commissioning scripts, operating procedures, and documentation habits that do not support the intended certification path.

The practical question is not "Should we get Tier III, Tier IV, or TIA-942?" The real project question is: "Which certification target matches the business need, and what design, construction, commissioning, vendor, and operations evidence must be controlled from the beginning?"

This is the certification-planning article in AakashX's Data Center Project Management in India series. It builds directly on project governance and testing and commissioning, within the pillar guide.

Table of Contents

  • What is the practical answer for data center certification planning?
  • Why should certification intent be decided early?
  • What is the difference between certification, commissioning, and handover?
  • What should teams know about Tier III and Tier IV?
  • How should teams think about Uptime Tier vs TIA-942?
  • What evidence is needed for design review?
  • What evidence is needed for constructed facility validation?
  • What operating evidence is needed before handover?
  • What usually fails in data center certification planning?
  • Data Center Certification Evidence Tracker
  • FAQ
  • Key Takeaways

What is the practical answer for data center certification planning?

Data center certification planning means deciding the target certification path early, translating it into design requirements, assigning evidence ownership, aligning vendor documentation, shaping commissioning scripts, and preparing operations for audit and handover.

Certification should be managed as a project workstream. It should not be treated as a label to be pursued after the facility is built.

Snippet-ready answer: Data center certification planning should define the target standard, design intent, evidence requirements, vendor deliverables, commissioning records, operations procedures, and audit-readiness gates before design freeze and procurement release.

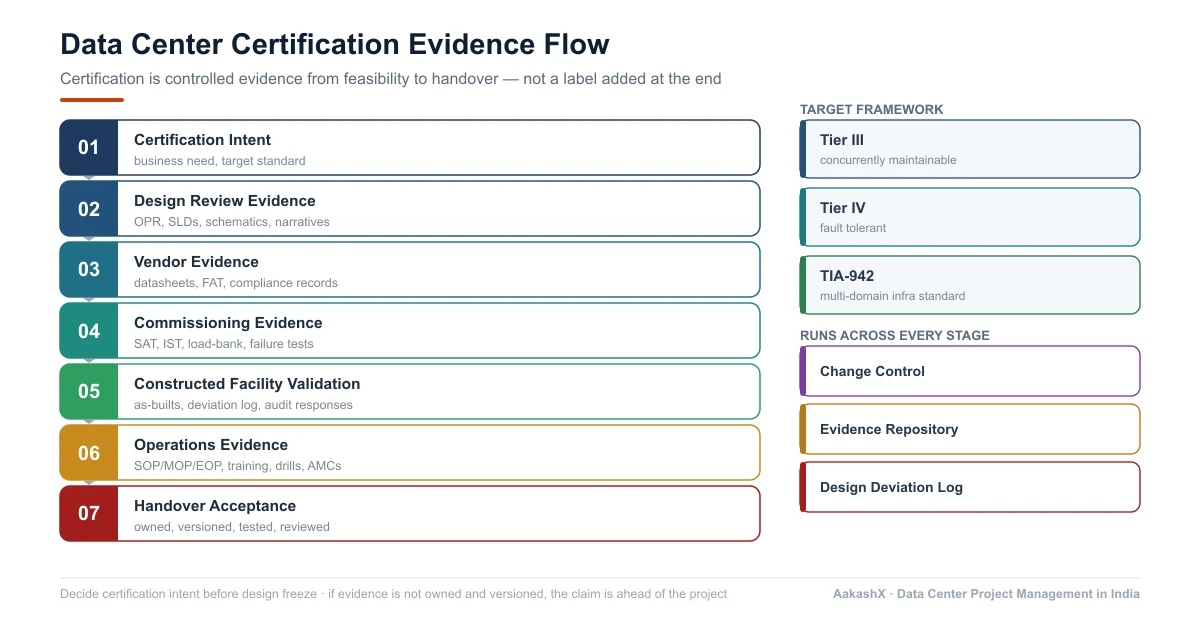

Data center certification evidence flow from certification intent through design review, vendor evidence, commissioning evidence, constructed facility validation, and operations evidence to handover, with Tier III, Tier IV, TIA-942, change control, and evidence repository side panels.
Data center certification evidence flow from certification intent through design review, vendor evidence, commissioning evidence, constructed facility validation, and operations evidence to handover, with Tier III, Tier IV, TIA-942, change control, and evidence repository side panels.

Why should certification intent be decided early?

Certification intent should be decided early because it affects architecture, redundancy, equipment selection, physical separation, maintainability, commissioning, documentation, vendor scope, and operations.

A late certification decision can create expensive rework.

Late certification decisionPossible impact
Higher resilience target chosen after designredesign of power, cooling, pathways, space, and redundancy
Certification body engaged latemissing design evidence and audit trail
Vendor documents not specifiedmissing FAT/SAT, compliance, and commissioning records
Equipment substitution approved casuallycertification conformance risk
Commissioning scripts written without certification intentweak evidence for constructed facility validation
Operations not involved earlyweak MOP/EOP/SOP and maintenance evidence
Design and as-built mismatchaudit and handover risk
Certification is not only a technical label. It is a project-control requirement.

The PMO should ask this question at feasibility:

Are we building to an internal resilience target, a customer requirement, a certification target, or a marketing claim?

Those are not the same thing.

What is the difference between certification, commissioning, and handover?

Certification, commissioning, and handover are connected, but they are not the same.

ConceptMeaningOutput
CommissioningProves systems work as designed, individually and togethertest records, issue closure, readiness evidence
CertificationValidates against a defined external standard or frameworkcertification report/certificate where achieved
HandoverTransfers operating responsibility to the operations teamSOPs, MOPs, EOPs, training, spares, AMCs, monitoring access

Commissioning vs certification

Commissioning proves that the facility works according to project requirements. Certification evaluates the facility against the selected framework or standard.

A facility can be commissioned but not certified. A facility can also have design-level certification but still need constructed-facility validation and operational readiness. The evidence generated during testing and commissioning is what feeds the certification audit.

Certification vs handover

Certification does not replace handover. Operations still needs documentation, staffing, monitoring, spares, preventive maintenance, emergency procedures, escalation paths, and training.

The cleanest sequence is:

Certification Intent
  -> Design Requirements
  -> Design Review Evidence
  -> Procurement and Vendor Evidence
  -> Construction Quality Evidence
  -> Commissioning Evidence
  -> Constructed Facility Validation
  -> Operations Readiness Evidence
  -> Handover Acceptance

What should teams know about Tier III and Tier IV?

Tier III and Tier IV are often discussed casually. That is risky.

At a project level, Tier III is associated with concurrent maintainability, and Tier IV adds fault tolerance. The exact design implications must be reviewed with the certification body and specialist consultants.

Tier III: concurrent maintainability

Concurrent maintainability means planned maintenance can be performed on capacity components and distribution paths without disrupting IT operations, assuming the facility is designed and operated to that standard.

Project implications may include maintainable power paths, maintainable cooling paths, planned maintenance procedures, physical access for maintenance, bypass arrangements, redundancy in critical systems, a clear isolation strategy, and commissioning tests that prove maintenance scenarios.

Tier IV: fault tolerance

Fault tolerance means the facility is designed so that an individual equipment failure or distribution path interruption should not affect IT operations, subject to the standard's requirements and the actual certified design.

Project implications may include stronger separation, more complex power and cooling topology, higher capital cost, more space, more commissioning complexity, more operational discipline, and stronger monitoring and response procedures.

Tier III vs Tier IV

Decision factorTier III planning implicationTier IV planning implication
Design goalmaintainability without planned downtimetolerate individual failure events
Complexityhighhigher
Capex impactmaterialhigher
Space impactmaterialhigher
Commissioning burdenstrongstronger
Operations disciplinerequiredstricter
Good fit whenbusiness needs maintainability and resiliencebusiness requires stronger fault tolerance
Do not publish uptime percentage claims unless they are sourced, contextualized, and legally reviewed. Certification language should be precise because buyers and auditors will notice loose claims.

How should teams think about Uptime Tier vs TIA-942?

Uptime Tier and TIA-942 are different certification frameworks. Do not treat them as interchangeable labels.

Uptime Tier

The Uptime Institute Tier framework focuses on infrastructure topology, availability, and operational sustainability through defined certification pathways such as design documents, constructed facility, and operational sustainability.

Use it when the project's main certification question is resilience, maintainability, fault tolerance, and operational alignment against the Tier framework.

TIA-942

ANSI/TIA-942 is a data center infrastructure standard. It covers physical infrastructure areas including site location, architecture, electrical, mechanical, fire safety, telecommunications, security, and other requirements. TIA also notes that TIA-942 Design Certification is valid for one year and Facilities Certification for three years, with surveillance audits before year one and year two and recertification by year three — so certification is an ongoing commitment, not a one-time event.

Use it when the project wants a broad infrastructure-standard approach covering multiple physical domains.

Uptime Tier vs TIA-942

FactorUptime TierTIA-942
Main orientationavailability / topology / operational sustainabilityphysical data center infrastructure standard
Common languageTier I–IVRated levels / design and facility certification
Scope emphasispower/cooling topology and operational sustainabilitysite, architecture, electrical, mechanical, telecom, fire, security
Project concernresilience and maintainability evidencemulti-domain infrastructure conformance
Planning needearly design and operations alignmentbroad design, build, and audit evidence
The right choice depends on customer requirements, investor expectations, internal risk appetite, regulatory or contractual commitments, and the facility's commercial positioning.

What evidence is needed for design review?

Design review evidence should be collected before procurement and construction decisions become hard to reverse.

Design evidence checklist

EvidenceWhy it matters
certification targetdefines evaluation path
owner's project requirementsaligns business and technical intent
design basis reportexplains load, redundancy, cooling, site, and operations assumptions
single-line diagramsshows electrical topology
mechanical schematicsshows cooling topology
architectural drawingsshows space, access, separation, fire, security
telecom/network designshows carrier, meet-me-room, pathway, diversity
fire/life-safety strategyshows detection, suppression, access, exits
BMS/DCIM/EPMS strategyshows monitoring and operations visibility
redundancy narrativeexplains N, N+1, 2N, or other assumptions
maintainability narrativeshows how planned maintenance will be performed
failure-mode assumptionsshows expected behavior during failures
approval alignmentshows authority and code dependencies
certification gap logcaptures open design gaps
Design evidence should be version-controlled. Certification review should not rely on scattered PDFs, vendor emails, or meeting recollection.

What evidence is needed for constructed facility validation?

Constructed facility validation needs proof that the facility was built according to the certified or reviewed design intent.

The project should collect approved-for-construction drawings, as-built drawings, a deviation log, change-control records, vendor submittals, material approval records, equipment datasheets, factory test records, site test records, installation certificates, inspection records, commissioning scripts, integrated systems testing records, load-bank test reports, failure scenario results, snag and closure records, BMS/DCIM point validation, fire-system test evidence, network route and testing evidence, security system test evidence, photo evidence where useful, and auditor observation responses.

Design intent vs as-built reality

A certification risk appears when design intent and as-built reality diverge.

Design intentAs-built risk
physically diverse pathscables or pipes routed through common point
maintainable componentsaccess blocked by layout or equipment placement
redundant coolingcontrols create hidden common failure mode
fire separationunsealed penetrations or late civil changes
network diversitycarriers share physical last-mile path
operations monitoringalarms missing or incorrectly mapped
The PMO should maintain a design deviation log and review certification impact before approving changes.

What operating evidence is needed before handover?

Operations evidence matters because certification and reliability are not only about design. A well-designed facility can still be operated poorly.

The operations team should prepare a staffing model, shift coverage plan, roles and responsibilities, SOPs, MOPs, EOPs, a preventive maintenance plan, a vendor AMC matrix, a spare parts list, an escalation matrix, an incident response process, access control procedures, a change-control procedure, monitoring dashboards, alarm response runbooks, a drill schedule, training records, an asset register, a maintenance calendar, a compliance calendar, and an audit evidence repository.

MOP, SOP, and EOP

DocumentMeaningExample
SOPStandard Operating Procedureroutine monitoring, access process, shift handover
MOPMethod of Procedureplanned maintenance on UPS, chiller, generator
EOPEmergency Operating Procedureutility failure, cooling failure, fire alarm, security incident
Operations evidence should be tested through drills, not only written into documents.

What usually fails in data center certification planning?

1. Certification is discussed after procurement

By then, equipment selection, topology, physical routing, and vendor documents may already be locked.

2. Design certification is confused with facility certification

A design review does not prove that the facility was built and commissioned exactly as required.

3. Teams use "Tier III-like" language

Loose phrases such as "Tier III compliant" or "Tier IV ready" can create buyer and audit confusion. Use precise language and verify claims with the certification body.

4. Vendor evidence is not contractually required

If FAT, SAT, datasheets, compliance records, test scripts, and commissioning support are not included in vendor scope, evidence collection becomes difficult.

5. Commissioning does not align with certification

Commissioning scripts should generate evidence for certification and handover. If scripts are generic, important failure scenarios may remain unproven.

6. Changes are approved without certification impact review

A seemingly small change in routing, equipment, access, controls, or vendor selection can affect certification evidence.

7. Operations is treated as a post-handover issue

Operations procedures, maintenance methods, staffing, training, escalation, monitoring, and drills should be prepared before handover.

8. Evidence is scattered

Certification planning fails when evidence lives in vendor emails, consultant folders, site chat groups, and disconnected PDFs. A central evidence tracker is mandatory.

Data Center Certification Evidence Tracker

Use this tracker from feasibility onward.

A. Certification decision gate

QuestionDecision / evidence
What certification path is being pursued?Uptime / TIA-942 / internal / other
What level/rating is targeted?define clearly
Why is certification needed?customer, investor, internal, commercial, risk
Who is the certification body or advisor?named party
Who owns evidence tracking?named owner
What is the budget impact?approved estimate
What is the schedule impact?integrated into master plan
What claims can be made publicly?legal/commercial review

B. Design evidence tracker

Evidence itemOwnerStatusCertification impact
owner's project requirementssponsor/PMOpendinghigh
design basis reportowner's engineerpendinghigh
electrical SLDselectrical consultantpendinghigh
mechanical schematicsMEP consultantpendinghigh
architectural drawingsarchitectpendinghigh
fire strategyfire consultantpendinghigh
telecom/network designnetwork leadpendingmedium/high
security designsecurity consultantpendingmedium/high
maintainability narrativeowner's engineerpendinghigh
failure-mode narrativecommissioning agencypendinghigh

C. Construction and commissioning evidence tracker

Evidence itemOwnerStatusCertification impact
as-built drawingsEPC / consultantspendinghigh
change-control logPMOpendinghigh
deviation logPMO / owner's engineerpendinghigh
FAT recordsvendorspendingmedium/high
SAT recordsvendorspendingmedium/high
IST recordscommissioning agencypendinghigh
load-bank test reportscommissioning agencypendinghigh
failure scenario reportscommissioning agencypendinghigh
BMS/DCIM validationBMS/DCIM teampendinghigh
fire system test evidencefire contractorpendinghigh
snag closure recordsPMO / contractorspendinghigh

D. Operations evidence tracker

Evidence itemOwnerStatusCertification / handover impact
SOPsoperationspendinghigh
MOPsoperations / vendorspendinghigh
EOPsoperationspendinghigh
staffing modeloperationspendinghigh
training recordsoperations / vendorspendingmedium/high
AMC matrixprocurement / operationspendingmedium/high
spares listoperations / vendorspendingmedium/high
escalation matrixoperationspendinghigh
monitoring dashboardsBMS/DCIM teampendinghigh
drill recordsoperationspendinghigh

Frequently Asked Questions About Data Center Certification Planning

What is data center certification planning?

Data center certification planning is the process of choosing the certification target and managing the design, construction, commissioning, vendor, and operations evidence needed to support it. It should start during feasibility and design, not after construction.

What is the difference between Tier III and Tier IV?

At a project level, Tier III is associated with concurrent maintainability, while Tier IV adds fault tolerance. The detailed implications depend on the selected certification framework, design, and certifying body review.

Is commissioning the same as certification?

No. Commissioning tests whether the facility performs according to project requirements. Certification validates the facility against a selected external framework or standard.

What is the difference between design certification and facility certification?

Design certification reviews whether the design meets the selected standard or framework. Facility certification validates whether the constructed facility matches the required design and performance expectations.

What is TIA-942 certification?

TIA-942 certification validates a data center against the ANSI/TIA-942 data center infrastructure standard. The standard covers multiple physical infrastructure domains, including architecture, electrical, mechanical, telecommunications, fire safety, security, and site-related requirements.

When should the certification body be engaged?

The certification body or certification advisor should be engaged before design freeze. Early engagement helps prevent design, procurement, commissioning, and documentation decisions from drifting away from the certification target.

Can a data center claim Tier III or Tier IV without certification?

Teams should be careful with public claims. Phrases such as "Tier III-like" or "Tier IV ready" can be misleading unless the scope, standard, and certification status are clear. Legal, commercial, and certification-body review should govern external claims.

What is the biggest certification planning mistake?

The biggest mistake is treating certification as an end-stage audit. Certification affects design, procurement, construction, commissioning, operations, documentation, and public claims from the beginning.

Key Takeaways

  • Data center certification planning should begin before design freeze and procurement release.
  • Certification, commissioning, and handover are related but different.
  • Tier III, Tier IV, and TIA-942 should not be used as loose marketing labels.
  • Design certification does not automatically prove the constructed facility or operations model.
  • Vendor evidence, commissioning scripts, change control, and as-built documentation must support the certification path.
  • Operations evidence such as SOPs, MOPs, EOPs, staffing, training, AMCs, spares, and drills should be prepared before handover.
  • A certification evidence tracker should be active from feasibility through handover.
This article is part of AakashX's Data Center Project Management in India field manual. Start with the master guide, Project Managing a Data Center Setup in India, revisit Data Center Testing and Commissioning, continue with Data Center Operations Handover, and work back through the full series. Before using words like Tier III, Tier IV, TIA-942, certified, compliant, or ready, build the certification evidence tracker above. If the evidence is not owned, versioned, tested, and reviewed, the claim is ahead of the project.

References

Data CentersTechnologyStrategySeriesJune 13, 2026
Share
Aakash Ahuja

Aakash Ahuja

Enterprise AI, Cybersecurity & Platform Engineering

Aakash writes about secure AI agents, microservices architecture, enterprise platforms, and production engineering. He has 20+ years of experience building and operating software systems across banking, cloud, cybersecurity, AI, and enterprise workflow automation. He is the founder of ITMTB and teaches AI, Big Data, and Reinforcement Learning at top institutes in India.
